Statistics & Highlights

Market Snapshot

Market size in Units
120 Units
2025
Base year
207 Units
2026
Estimated

3,200 Units
2031
Forecast
Largest market
Western Cape
Fastest growing
Municipal Bus Rapid Transit Authorities
Dominant segment
Private Commuter Bus Operators
Concentration
Highly Concentrated
CAGR
72.85%
2026 – 2031
GROWTH
+3,080 Units
Absolute
STUDY PARAMETERS
Base year2025
Historical period2021 – 2025
Forecast period2026 – 2031
Units consideredVolume (Units)
REPORT COVERAGE
Segments covered5 dimensions / 16 segments
Regions covered4
Companies profiled14+
Report pages250+
DeliverablesPDF, Excel, PPT
Executive Summary

Key Takeaways

The committed electric bus fleet reaches 3,200 units by 2031 from 120 in 2025, with the research pack's narrower 2026 to 2031 window running at 39.40% against the six-year rate of 72.85%.
Golden Arrow operates 120 electric buses within a fleet of approximately 1,200, roughly 10% electrified, on a total investment of R750 million and just under four million kilometres of operating data.
At a recapitalisation rate of 60 to 65 buses a year, full fleet conversion at the largest operator takes approximately 18 years, which caps how fast contracted volumes become operating buses.
Arrowgate required grid supply to rise from 1 MW to 6 MW for about 100 buses, an implied 60 kW per bus that scales to roughly 192 MW nationally at the 2031 forecast.
Two independent contracts imply almost the same capital cost per bus including infrastructure, at USD 333,333 from the Kiira agreement and USD 341,530 from the Golden Arrow investment, a 2.46% difference.
Local bodying is the near-term localisation route, with 38 Volvo BZR Low Entry Electric chassis to be bodied by Gauteng Bus and Coach Centre for delivery from 2027.
Market Insights

Market Overview & Analysis

Report Summary

South Africa's electric bus market is small, concentrated and unusually well evidenced. Three procurement decisions account for essentially all committed volume, one operator holds almost all operating experience, and a single depot demonstrates the infrastructure ratio that every subsequent deployment must satisfy. That combination makes the market easy to size and hard to forecast.

The measure used here is an operating plus firmly contracted fleet proxy rather than annual registrations. Delivery schedules span several years and procurement quantities differ from deliveries in any given year, so a registration series would understate commitment while a pipeline series would overstate capability. The proxy sits between them and is stated as such throughout.

The analysis is written for vehicle and chassis suppliers assessing tender requirements, bus bodybuilders evaluating localisation opportunities, charging and grid contractors sizing depot work, municipalities and operators building business cases, and financiers underwriting fleet transactions. It treats the economic unit as a depot solution rather than as a bus, because chargers, grid upgrades, civil works, software, financing and maintenance determine whether a contract closes.

South Africa Electric Bus Market Size and Forecast

The committed electric bus fleet is estimated at 120 units in 2025, rising to 608 in 2026 and 3,200 by 2031. The 2025 figure is the BYD programme delivering 120 buses to Golden Arrow Bus Services, treated as the first fleet-scale commercial block rather than as a national registration statistic. The 2026 figure adds the 450-bus Kiira Motors agreement and the 38-bus Volvo order for the City of Cape Town.

Two growth rates apply and the spread between them is the widest in this research programme. The six-year rate connecting 2025 and 2031 is 72.85%. The five-year rate connecting 2026 and 2031 is 39.40%. The 33.45-point gap exists because the 2026 figure incorporates two contract signatures worth 488 units, a 406.67% single-year increase that no subsequent year can repeat.

Neither rate should be used for planning and the reason is structural rather than statistical. Procurement is concentrated in a few large buyers, so the series moves in discrete blocks when a contract is signed rather than continuously as demand accumulates. A compound rate applied to this market will be wrong in every intermediate year even if it happens to be right at the endpoints.

The 2031 forecast assumes several municipal and private operators replicate the depot-based model that Golden Arrow and Cape Town have established, constrained by grid capacity, charging capital expenditure, grant funding and local bodying capacity. It is a scenario built on repeatability of a demonstrated template, not an extrapolation of contracting activity.

Fleet capital value moves from approximately USD 40 million to USD 960 million across the forecast, on a per-bus convention including charging infrastructure that falls from about USD 333,333 to USD 300,000 as local bodying substitutes for imported complete vehicles. Value therefore compounds at 69.84% against 72.85% for units, because the cost of a bus declines as the market scales.

Two Contracts, One Cost per Bus

The strongest validation available in this market is that two unrelated transactions imply almost the same capital requirement. Golden Arrow's April 2026 agreement with Uganda's Kiira Motors Corporation covers 450 electric buses with charging infrastructure at a reported USD 150 million, which is USD 333,333 per bus including infrastructure.

Separately, Golden Arrow's own reported total investment in its 120-bus electric programme is R750 million, which at a constant ZAR 18.30 per USD is USD 341,530 per bus. The two figures differ by 2.46%, and they were arrived at through entirely different routes: one a forward procurement contract with an intra-African supplier, the other retrospective capital expenditure on a delivered Chinese fleet.

That convergence is what allows a capital value series to be published at all in a market with three transactions. It also sets the benchmark a new entrant must beat, and it prices the depot rather than the vehicle, which is the correct unit for anyone underwriting this market.

Grid Capacity Is the Binding Constraint

Smart EV completed a 50-charger electric bus hub at Golden Arrow's Arrowgate depot in Cape Town in December 2025, installing 30 plus 20 dual-gun 120 kW direct-current chargers and increasing grid supply from 1 MW to 6 MW. That allowed the depot to charge as many as 100 buses in about 90 minutes when required, and the installation has since grown to 60 direct-current charging stations serving up to 120 buses.

The ratio embedded in that project is the single most transferable number in this market. A sixfold grid uplift for roughly 100 buses implies about 60 kW of depot grid capacity per bus in high-throughput operation. Applied to the 3,200-unit 2031 forecast, that implies approximately 192 MW of new depot grid capacity nationally, and to the 608-unit 2026 committed fleet about 36 MW.

Electricity connection lead times and funding availability are therefore the most important practical constraints on how quickly contracted fleet volumes become operating buses. A bus can be ordered in a quarter and bodied in a year; a municipal or industrial grid connection upgrade of that scale is a multi-year civil and utility process that no procurement decision can accelerate.

Golden Arrow has partially answered the question with generation rather than only with connection. Solar installations produced 3,266 megawatt hours over a twelve-month period, equivalent to powering approximately 3.3 million kilometres of operation, which implies energy consumption of roughly 0.99 kilowatt hours per kilometre and demonstrates on-site generation as a route around constrained supply.

Recapitalisation Rate Caps the Transition

Golden Arrow operates approximately 1,200 buses and replaces 60 to 65 of them each year. At that rate, converting the entire fleet takes roughly 18 years even if every replacement bus is electric and no financial or grid constraint intervenes. The 120 electric buses currently operating represent about 10% of the fleet and roughly two years of normal recapitalisation.

That arithmetic reframes the market for a supplier. Demand is not created by a decision to electrify; it is released by the replacement cycle, and a bus bought today removes a procurement opportunity for roughly fifteen years. Winning a tender is therefore worth far more than its unit count suggests, and losing one closes the account for longer than most sales plans assume.

It also explains why the Kiira agreement matters disproportionately. At 450 buses it is roughly seven years of Golden Arrow's normal recapitalisation compressed into one contract, which is only possible because it is an additional electrification programme rather than a like-for-like replacement, and which is why its delivery schedule spans multiple years.

Municipal Procurement and the Cape Town Template

Volvo Buses announced an order for 38 BZR Low Entry Electric buses for the City of Cape Town in August 2026, funded through the Public Transport National Grant, with bodies to be manufactured locally by Gauteng Bus and Coach Centre and first deliveries scheduled from 2027. The city has stated that 38 is a minimum and that the number may increase with funding availability.

Cape Town began real-world testing of its first twelve-metre Volvo BZR Low Entry Electric MyCiTi bus in July 2026 on demanding urban routes, assessing battery performance, energy consumption, charging time, passenger loading and route conditions ahead of wider rollout. The prototype is locally bodied, which makes the pilot a test of the supply chain as well as of the vehicle.

The vehicle itself is specified for the duty rather than for the headline. The BZR Low Entry Electric carries up to 630 kilowatt hours nominally across seven battery packs of 90 kilowatt hours each, which is substantially more than the 230 kilowatt hours of the BYD B12 units at Golden Arrow and reflects a different route profile and charging strategy rather than a better vehicle.

Municipal procurement depends on public transport grants and on grid infrastructure, which is why the funding source is stated in the announcement and why quantities are expressed as minimums. Procurement quantities and actual annual deliveries differ, and any market tracking that conflates the two will overstate near-term volumes while understating commitment.

Local Bodying as the Practical Localisation Route

The Cape Town order establishes the intermediate localisation model that this market is likely to follow: imported chassis and drivetrain with locally manufactured bodies. Gauteng Bus and Coach Centre bodies the 38 Volvo units in Johannesburg, which captures value and employment domestically without requiring full chassis manufacturing capability.

That route has a policy tailwind. The 150% first-year manufacturing allowance supports local battery-electric production investment, and local bodying demonstrates a qualifying activity at a scale a bus market can actually support, unlike a full vehicle plant sized for a 3,200-unit market over six years.

Bodying and aftersales capability are also emerging as tender differentiators rather than only as cost decisions. A supplier offering local bodies, local parts and local technical support answers the availability and residual questions a municipality must satisfy to justify grant expenditure, which is a different competition from the one fought on vehicle specification.

The Depot Solution Is the Product

For market entry, the economic unit is a fleet or depot solution rather than a bus. Chargers, grid upgrade, civil works, depot management software, financing and maintenance determine bankability, and the Arrowgate project demonstrates the point precisely: 60 charging stations and a grid uplift from 1 MW to 6 MW are the deliverable, not an accessory to it.

This creates a competitive layer around vehicle manufacturers that is at least as important as the vehicles themselves. Bus body builders, charging integrators, civil works contractors, grid upgrade specialists, telematics providers and depot management software vendors all participate in the same transaction, and a vehicle supplier without partners across that stack is bidding on part of the problem.

It also changes who the customer is. A municipality buying 38 buses is procuring a transport service capability, and the winning proposition addresses energy supply, depot works, driver training, maintenance and data as one package. The Kiira agreement bundling 450 buses with charging infrastructure is the clearest expression of that logic in the market to date.

Intra-African Supply and AfCFTA

The Kiira Motors agreement is the first significant intra-African vehicle procurement in this market and it establishes a precedent worth watching. A Ugandan manufacturer supplying 450 electric buses with charging infrastructure to a South African operator is a continental supply relationship rather than an import from Asia or Europe, and it operates inside the framework the African Continental Free Trade Area is intended to enable.

Certification, homologation and aftersales obligations remain the practical tests. A 450-bus contract creates parts, service and warranty obligations across a multi-year delivery schedule, and those are precisely the capabilities a newer manufacturer must demonstrate rather than assert. The contract's execution will be more informative than its signature.

For established suppliers the competitive implication is direct. BYD holds the operating incumbency through 120 delivered buses and just under four million kilometres of data; Volvo holds the municipal beachhead with local bodying; Kiira holds the largest single contract at 450 units. Three different entry strategies are being tested simultaneously in a market of fewer than 700 committed vehicles.

Market Dynamics

Key Drivers

  • A demonstrated operating template, with 120 buses covering just under four million kilometres and a depot supporting up to 120 vehicles on 60 direct-current charging stations.
  • Grant-funded municipal procurement, with the 38-bus Cape Town order funded through the Public Transport National Grant and stated as a minimum subject to funding availability.
  • Fleet-scale contracting, with the 450-bus Kiira Motors agreement at a reported USD 150 million including charging infrastructure.
  • Local bodying capacity, with Gauteng Bus and Coach Centre bodying Volvo BZR Low Entry Electric chassis for delivery from 2027 alongside a 150% first-year manufacturing allowance.
  • On-site generation economics, with 3,266 megawatt hours of solar output over twelve months covering approximately 3.3 million kilometres of operation.

Key Restraints

  • Grid connection capacity and lead times, with an implied requirement of roughly 60 kW per bus scaling to about 192 MW nationally at the 2031 forecast.
  • Recapitalisation rate, with 60 to 65 buses replaced a year against a 1,200-bus fleet implying roughly 18 years for full conversion at the largest operator.
  • Capital cost per unit, at approximately USD 333,333 to USD 341,530 per bus including infrastructure on the two available reference contracts.
  • Buyer concentration, with three procurement decisions accounting for essentially all of the 608-unit committed fleet in 2026.

Key Trends

  • Bundled procurement, with vehicles and charging infrastructure contracted together as in the USD 150 million Kiira agreement.
  • Local bodying of imported chassis as the intermediate localisation route, demonstrated on 38 Volvo units for Cape Town.
  • Intra-African supply relationships, with a Ugandan manufacturer holding the largest single contract in the South African market.
  • Divergent battery strategies, with 630 kilowatt hour Volvo specifications against 230 kilowatt hour BYD units reflecting different route and charging profiles.
South Africa Electric Bus Market Dynamics Segment Analysis Infographic
Segment Analysis

Market Segmentation

Private Commuter Bus Operators
Leading

The category holding essentially all operating experience in the country, anchored by Golden Arrow Bus Services with 120 electric buses inside a fleet of approximately 1,200 and a total investment of R750 million. These operators fund from balance sheet and contract revenue rather than from grants, which makes their procurement faster to close and harder to scale.

Municipal Bus Rapid Transit Authorities

The segment that will drive volume growth, opened by the City of Cape Town's 38-unit Volvo order funded through the Public Transport National Grant and stated as a minimum. Municipal procurement moves in grant cycles rather than in commercial cycles, which makes quantities larger and timelines less predictable than private operator purchases.

Corporate and Institutional Fleets

Staff transport, mining shuttle, university and airport operations are effectively unrepresented in the 608-unit committed fleet as of 2026, despite route profiles that suit electric operation particularly well. Fixed routes, depot returns and predictable duty cycles are exactly the conditions the 0.99 kilowatt hour per kilometre consumption evidence rewards.

Chinese Suppliers
Leading

The incumbent position by delivered volume, with BYD supplying the 120-bus Golden Arrow programme using B12 units carrying 230 kilowatt hour batteries and charging in approximately two hours. Chinese suppliers hold the only substantial South African operating dataset, at just under four million kilometres, which is a tender asset no competitor can currently match.

European Suppliers

Represented principally by Volvo Buses through the 38-unit BZR Low Entry Electric order for Cape Town, specified at up to 630 kilowatt hours across seven 90 kilowatt hour packs. The European entry route is municipal procurement combined with local bodying rather than fleet-scale private contracting.

Intra-African Suppliers

Established by Kiira Motors Corporation's 450-bus agreement with Golden Arrow at a reported USD 150 million including charging infrastructure, the largest single contract in the market. The segment's credibility rests on execution of certification, homologation and aftersales obligations across a multi-year delivery schedule rather than on the contract value.

Operating Fleet
Leading

The 120 buses delivered to Golden Arrow, carrying just under four million kilometres of accumulated operating data at approximately 33,333 kilometres per bus. This is the only stage generating real energy consumption, reliability and maintenance evidence, which is why a single operator's experience currently defines national assumptions.

Contracted and Funded

The 488 units added in 2026 through the 450-bus Kiira agreement and the 38-bus Cape Town order, taking the committed proxy to 608. These are firm commitments with identified funding whose delivery schedules span multiple years, and they are the reason committed fleet and operating fleet must be tracked as separate series.

Announced and Unfunded

Municipal and operator intentions beyond currently funded orders, including Cape Town's statement that its 38-unit order is a minimum that may increase with funding availability. This stage is excluded from the committed proxy entirely, because the gap between a stated intention and a grant allocation is where most electric bus pipelines in emerging markets are lost.

Twelve Metre Standard Buses
Leading

The dominant class in commuter operation and the format of both the BYD B12 units at Golden Arrow and the Volvo BZR Low Entry Electric prototype that Cape Town began testing in July 2026. Standard twelve-metre vehicles carry the duty cycles that justify batteries between 230 and 630 kilowatt hours.

Low Entry and Low Floor Buses

The configuration municipal bus rapid transit procurement requires for accessibility, and the specification of all 38 Volvo units ordered by the City of Cape Town. Low floor architecture constrains battery packaging, which is part of why the Volvo specification reaches 630 kilowatt hours across seven separate packs.

Midi and Feeder Buses

Smaller vehicles serving feeder routes and lower-density corridors, effectively absent from the 608-unit committed fleet despite representing a substantial share of South African passenger transport. Lower energy requirements per vehicle would reduce the 60 kW per bus depot grid ratio that constrains standard bus deployments.

Vehicles and Chassis
Leading

The layer attracting most attention and roughly the smaller part of a transaction priced at USD 333,333 to USD 341,530 per bus including infrastructure. Three suppliers account for all committed volume, and none holds a position secure enough to be described as established across more than one customer.

Local Bodying and Assembly

The practical localisation route, demonstrated by Gauteng Bus and Coach Centre bodying 38 Volvo chassis in Johannesburg for delivery from 2027. It captures domestic value and employment at a scale a 3,200-unit six-year market can support, which full chassis manufacturing cannot.

Depot Charging and Grid Infrastructure

The layer that determines whether contracted buses become operating buses, exemplified by Arrowgate's 60 direct-current charging stations and a grid uplift from 1 MW to 6 MW. At roughly 60 kW per bus, the 2031 forecast implies approximately 192 MW of national depot grid capacity, which is a larger undertaking than the vehicle procurement it enables.

Depot Software and Maintenance Services

Charge scheduling, energy management, telematics and maintenance capability determine whether a depot can turn 100 buses in about 90 minutes as Arrowgate is designed to do. This layer is where the operating dataset of just under four million kilometres converts into competitive advantage, and it is the least contested part of the value chain today.

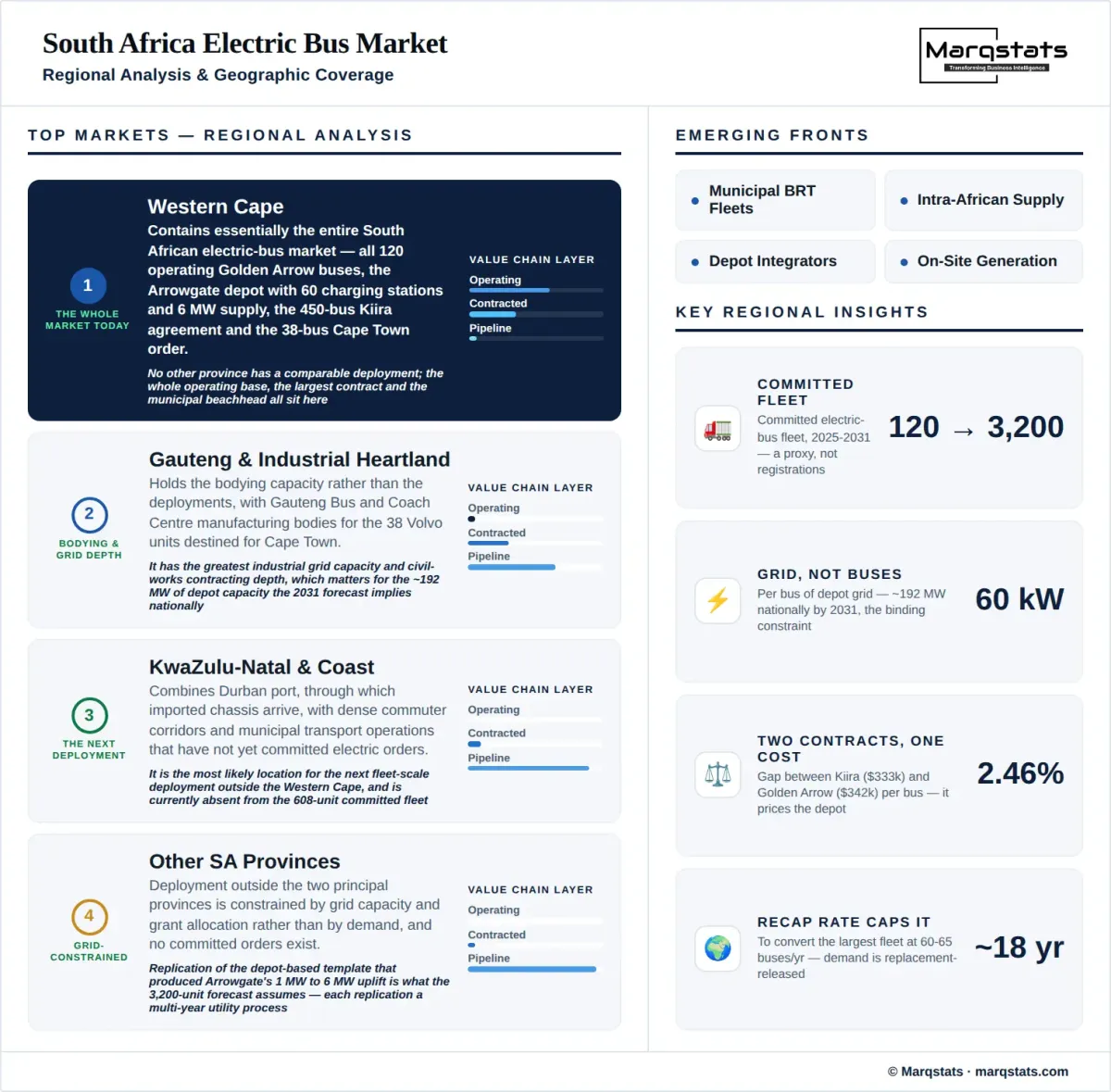

Regional Analysis

By Geography

Gauteng and the Industrial Heartland

Gauteng holds the bodying capacity rather than the deployments, with Gauteng Bus and Coach Centre in Johannesburg manufacturing bodies for the 38 Volvo units destined for Cape Town. It is also where industrial grid capacity and civil works contracting depth are greatest, which matters for the roughly 192 MW of depot capacity the 2031 forecast implies nationally.

Western Cape

The Western Cape contains essentially the entire South African electric bus market today, including all 120 operating Golden Arrow buses, the Arrowgate depot with its 60 charging stations and 6 MW supply, the 450-bus Kiira agreement and the 38-bus City of Cape Town order. No other province has a comparable deployment.

KwaZulu-Natal and the Coastal Corridor

KwaZulu-Natal combines Durban port, through which imported chassis arrive, with dense commuter corridors and municipal transport operations that have not yet committed electric orders. It is the most likely location for the next fleet-scale deployment outside the Western Cape and is currently absent from the 608-unit committed fleet.

Other South African Provinces

Deployment outside the two principal provinces is constrained by grid capacity and grant allocation rather than by demand, and no committed orders exist. Replication of the depot-based template that produced Arrowgate's 1 MW to 6 MW uplift is what the 3,200-unit 2031 forecast assumes, and each replication is a multi-year utility process.

South Africa Electric Bus Market Regional Analysis Infographic

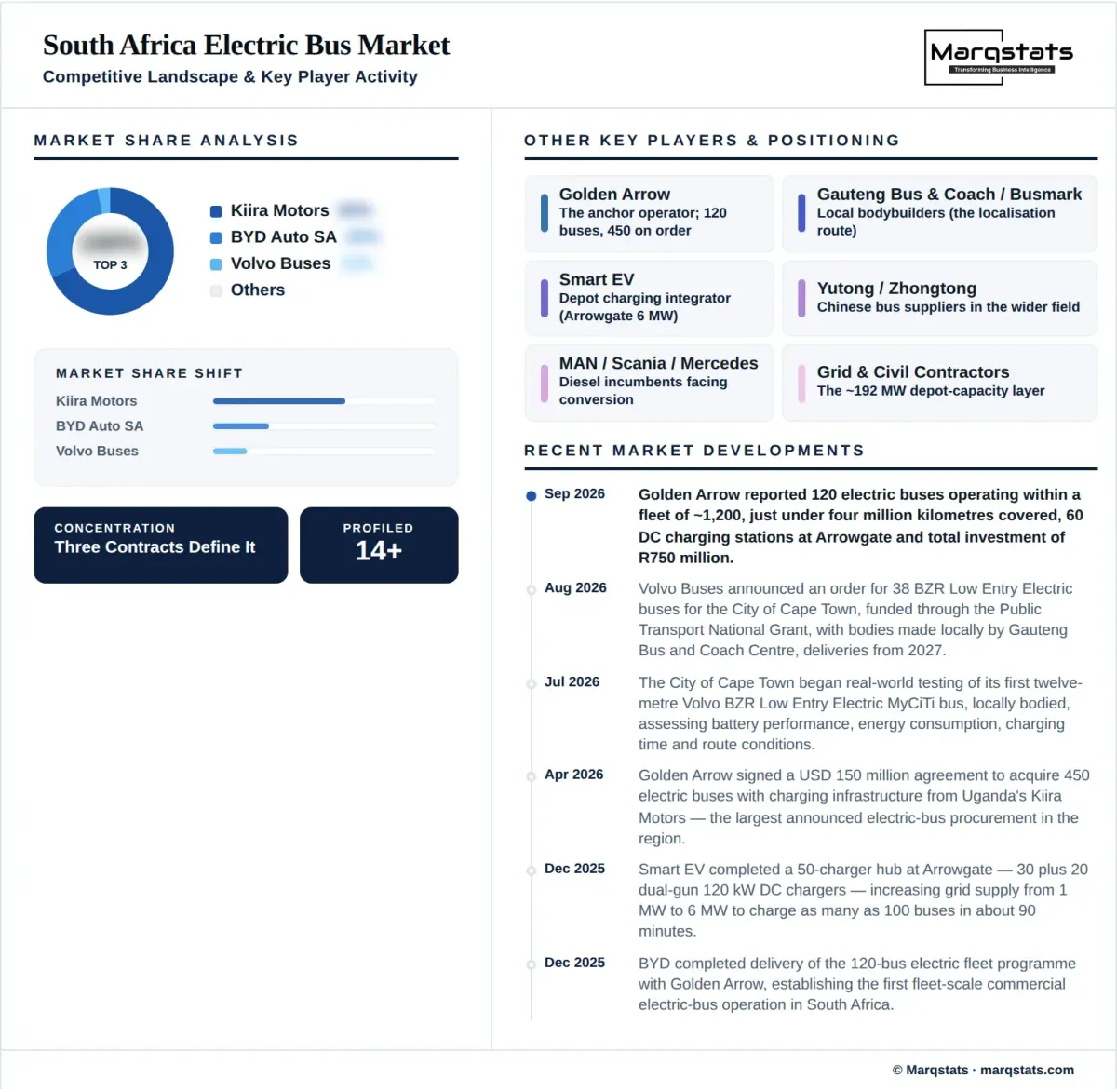

Competitive Landscape

How Competition Is Evolving

This is a market of three transactions and three entry strategies being tested at once. BYD holds operating incumbency through 120 delivered buses at Golden Arrow and just under four million kilometres of accumulated data. Volvo holds the municipal beachhead through 38 BZR Low Entry Electric units for Cape Town with local bodying. Kiira Motors holds the largest single contract at 450 buses.

None of those positions is yet secure across more than one customer. A supplier with one anchor account in a market whose committed fleet totals 608 units has demonstrated capability rather than established share, and the next two or three procurement decisions will determine the structure far more than the existing three have.

The operating dataset is currently the most valuable competitive asset in the market. Just under four million kilometres of South African duty-cycle evidence, energy consumption near 0.99 kilowatt hours per kilometre and demonstrated depot throughput answer the questions a municipal business case must address, and they cannot be acquired except by operating.

The ecosystem layer competes on different terms and may capture more durable value. Smart EV delivered the Arrowgate charging hub, Gauteng Bus and Coach Centre bodies the Volvo chassis, and civil works, grid upgrade, telematics and depot management suppliers participate in every transaction regardless of which vehicle manufacturer wins it.

For an investor, the decisive question is whether a position is buyer-specific or capability-specific. Vehicle supply in this market is won account by account against concentrated buyers with long replacement cycles; charging, bodying and depot capability are won once and reused across every subsequent deployment, which is a materially better shape of revenue in a market this concentrated.

South Africa Electric Bus Market Competitive Landscape Infographic
Major Players

Companies Covered

The report profiles 14+ companies with full strategy and financials analysis, including:

Golden Arrow Bus Services
BYD Auto South Africa
Volvo Buses Southern Africa
Kiira Motors Corporation
Gauteng Bus and Coach Centre
Smart EV
MAN Automotive South Africa
Scania South Africa
Mercedes-Benz South Africa
Marcopolo South Africa
Busmark 2000
MCV Bus and Coach
Yutong Bus and Coach
Zhongtong Bus Holding Company
Note: Full company profiles include revenue analysis, product portfolio, SWOT, and recent strategic developments.
Latest Developments

Recent Market Activity

Sep 2026
Golden Arrow reports 120 electric buses operating within a fleet of approximately 1,200, just under four million kilometres covered, 60 direct-current charging stations at Arrowgate and total investment of R750 million.
Aug 2026
Volvo Buses announces an order for 38 BZR Low Entry Electric buses for the City of Cape Town, funded through the Public Transport National Grant, with bodies manufactured locally by Gauteng Bus and Coach Centre and deliveries from 2027.
Jul 2026
The City of Cape Town begins real-world testing of its first twelve-metre Volvo BZR Low Entry Electric MyCiTi bus, locally bodied, assessing battery performance, energy consumption, charging time and route conditions.
Apr 2026
Golden Arrow Bus Services signs a USD 150 million agreement to acquire 450 electric buses with charging infrastructure from Uganda's Kiira Motors Corporation, the largest announced electric bus procurement in the region.
Dec 2025
Smart EV completes a 50-charger electric bus hub at Golden Arrow's Arrowgate depot, installing 30 plus 20 dual-gun 120 kW direct-current chargers and increasing grid supply from 1 MW to 6 MW to charge as many as 100 buses in about 90 minutes.
Dec 2025
BYD completes delivery of the 120-bus electric fleet programme with Golden Arrow, establishing the first fleet-scale commercial electric bus operation in South Africa.
Report Structure

Table of Contents

1. Introduction
1.1 Study Assumptions and Market Definition
1.1.1 The Operating Plus Firmly Contracted Fleet Proxy
1.1.2 Why Annual Registrations Would Understate Commitment
1.1.3 Why an Announcement Pipeline Would Overstate Capability
1.1.4 Exclusion of Announced but Unfunded Intentions
1.1.5 Fleet Capital Value as a Separate Reference Series
1.1.6 Six-Year CAGR Convention and Why It Should Not Be Used
1.2 Research Scope and Boundaries
1.2.1 Buses Only, Excluding Minibus Taxi Electrification
1.2.2 The Depot Solution as the Economic Unit
1.2.3 Why Procurement Quantities and Deliveries Differ
1.3 Data Confidence and Source Architecture
1.3.1 Three Transactions and What They Support
1.3.2 Two Independently Reported Per-Bus Cost Figures
1.3.3 The Grid Ratio as a Derived Planning Benchmark
2. Executive Summary and Key Findings
2.1 Small, Concentrated and Unusually Well Evidenced
2.1.1 Why the Headline Growth Rate Should Not Be Used
2.1.2 Electricity Rather Than Vehicle Supply as the Constraint
2.1.3 Recapitalisation Rate as the Ceiling on Conversion
2.2 Headline Series
2.2.1 Committed Fleet 120 to 3,200 Units
2.2.2 Fleet Capital Value USD 40 Million to USD 960 Million
3. Market Dynamics and Structural Analysis
3.1 South Africa Electric Bus Market Size and Forecast
3.1.1 The 120-Bus BYD Programme as the 2025 Anchor
3.1.2 The 608-Unit 2026 Proxy and What It Adds
3.1.3 A 33.45-Point Spread Between Two Growth Rates
3.1.4 Why the 2031 Scenario Rests on Template Repeatability
3.2 Two Contracts, One Cost per Bus
3.2.1 USD 333,333 From the Kiira Agreement
3.2.2 USD 341,530 From the R750 Million Investment
3.2.3 Why Convergence Permits a Value Series at All
3.3 Grid Capacity Is the Binding Constraint
3.3.1 The Arrowgate 1 MW to 6 MW Uplift
3.3.2 Roughly 60 kW of Depot Capacity per Bus
3.3.3 Approximately 192 MW at the 2031 Forecast
3.3.4 On-Site Generation as a Route Around Constrained Supply
3.4 Recapitalisation Rate Caps the Transition
3.4.1 Sixty to Sixty-Five Buses a Year Against 1,200
3.4.2 Why a Tender Is Worth More Than Its Unit Count
3.4.3 Why the Kiira Agreement Matters Disproportionately
3.5 Municipal Procurement and the Cape Town Template
3.5.1 Thirty-Eight Volvo Units Under Grant Funding
3.5.2 The July 2026 Locally Bodied Prototype
3.5.3 Battery Specification and Route Profile
3.5.4 Why Quantities Are Expressed as Minimums
3.6 Local Bodying as the Practical Localisation Route
3.6.1 Imported Chassis With Locally Manufactured Bodies
3.6.2 The Manufacturing Allowance and Qualifying Activity
3.6.3 Bodying and Aftersales as Tender Differentiators
3.7 The Depot Solution Is the Product
3.7.1 Chargers, Civil Works, Software and Financing
3.7.2 The Competitive Layer Around Vehicle Manufacturers
3.7.3 Why Bundled Procurement Is Becoming Standard
3.8 Intra-African Supply and AfCFTA
3.8.1 The Kiira Precedent and What It Establishes
3.8.2 Certification, Homologation and Aftersales Obligations
3.8.3 Three Entry Strategies Tested Simultaneously
3.9 Key Drivers
3.9.1 A Demonstrated Operating Template
3.9.2 Grant-Funded Municipal Procurement
3.9.3 Fleet-Scale Contracting
3.9.4 Local Bodying Capacity
3.9.5 On-Site Generation Economics
3.10 Key Restraints
3.10.1 Grid Connection Capacity and Lead Times
3.10.2 Fleet Recapitalisation Rate
3.10.3 Capital Cost per Unit
3.10.4 Buyer Concentration
3.11 Key Trends
3.11.1 Bundled Vehicle and Infrastructure Procurement
3.11.2 Local Bodying of Imported Chassis
3.11.3 Intra-African Supply Relationships
3.11.4 Divergent Battery and Charging Strategies
4. Market Segmentation — By Operator Type
4.1 Private Commuter Bus Operators
4.1.1 Balance-Sheet Funding and Faster Closure
4.1.2 Where All Operating Experience Currently Sits
4.2 Municipal Bus Rapid Transit Authorities
4.2.1 Grant Cycles Rather Than Commercial Cycles
4.3 Corporate and Institutional Fleets
4.3.1 Fixed Routes and Depot Returns as Unexploited Fit
5. Market Segmentation — By Supplier Origin
5.1 Chinese Suppliers
5.1.1 Operating Incumbency as a Tender Asset
5.2 European Suppliers
5.2.1 Municipal Procurement Combined With Local Bodying
5.3 Intra-African Suppliers
5.3.1 Execution Rather Than Contract Value as the Test
6. Market Segmentation — By Deployment Stage
6.1 Operating Fleet
6.1.1 The Only Stage Generating Operating Evidence
6.2 Contracted and Funded
6.2.1 Why Committed and Operating Must Be Tracked Separately
6.3 Announced and Unfunded
6.3.1 Where Emerging-Market Bus Pipelines Are Usually Lost
7. Market Segmentation — By Bus Class
7.1 Twelve Metre Standard Buses
7.1.1 The Duty Cycles That Justify Large Batteries
7.2 Low Entry and Low Floor Buses
7.2.1 Accessibility Requirements and Battery Packaging
7.3 Midi and Feeder Buses
7.3.1 Lower Energy Requirements and Reduced Grid Ratio
8. Market Segmentation — By Value Chain Layer
8.1 Vehicles and Chassis
8.1.1 Three Suppliers, None Secure Across Two Customers
8.2 Local Bodying and Assembly
8.2.1 Value Capture at a Scale This Market Can Support
8.3 Depot Charging and Grid Infrastructure
8.3.1 The Layer That Determines Whether Buses Operate
8.4 Depot Software and Maintenance Services
8.4.1 Where Operating Data Becomes Competitive Advantage
9. Regional Analysis
9.1 Gauteng and the Industrial Heartland
9.1.1 Bodying Capacity Without Deployments
9.2 Western Cape
9.2.1 Essentially the Entire National Market
9.3 KwaZulu-Natal and the Coastal Corridor
9.3.1 The Most Likely Next Fleet-Scale Deployment
9.4 Other South African Provinces
9.4.1 Grid Capacity and Grant Allocation as Constraints
10. Competitive Landscape
10.1 Three Transactions and Three Entry Strategies
10.2 Buyer-Specific Against Capability-Specific Positions
10.3 Company Profiles
10.3.1 Golden Arrow Bus Services
10.3.2 BYD Auto South Africa
10.3.3 Volvo Buses Southern Africa
10.3.4 Kiira Motors Corporation
10.3.5 Gauteng Bus and Coach Centre
10.3.6 Smart EV
10.3.7 MAN Automotive South Africa
10.3.8 Scania South Africa
10.3.9 Mercedes-Benz South Africa
10.3.10 Marcopolo South Africa
10.3.11 Busmark 2000
10.3.12 MCV Bus and Coach
10.3.13 Yutong Bus and Coach
10.3.14 Zhongtong Bus Holding Company
11. Market Opportunities and Future Outlook
11.1 Charging and Grid Capability as Repeatable Revenue
11.2 Corporate and Institutional Fleets as Unexploited Demand
11.3 Depot Software and Energy Management
12. Appendix
12.1 Abbreviations and Defined Terms
12.2 Contract Register, Per-Bus Cost and Grid Ratio Assumptions
12.3 Source Register
Study Scope & Focus

Coverage & Segmentation

This study measures the operating plus firmly contracted electric bus fleet in South Africa from 2021 to 2031, with 2025 as the base year and 2026 to 2031 as the forecast period. The proxy is used instead of annual registrations because delivery schedules span multiple years and procurement quantities differ from deliveries in any given year, and announced but unfunded intentions are excluded entirely.

Coverage spans three operator types, three supplier origins, three deployment stages, three bus classes and four value chain layers, alongside four provincial clusters analysed on deployment concentration, bodying capacity and grid conditions rather than quantified share. Fleet capital value is carried as a reference series in USD at a constant ZAR 18.30 conversion, on a per-bus convention derived from two independently reported contract values. Fourteen entities are profiled across operators, vehicle suppliers, bodybuilders and infrastructure providers.

Frequently Asked Questions

FAQs About the South Africa Electric Bus Market

Approximately 120 as of September 2026, all operated by Golden Arrow Bus Services in Cape Town under a delivery programme with BYD. They sit within a total Golden Arrow fleet of around 1,200 vehicles, making the country's largest commuter operator roughly 10% electrified, and they had covered just under four million kilometres — about 33,333 kilometres per bus. The committed fleet including firmly contracted but undelivered units is 608, after adding the 450-bus Kiira Motors agreement and the 38-bus City of Cape Town order. Operating fleet and committed fleet must be tracked as separate series, because delivery schedules span multiple years.
Golden Arrow has committed to 570 electric buses in total across two agreements. The first is the BYD programme of 120 buses, now delivered and operating, on a reported total investment of R750 million. The second is an April 2026 agreement with Uganda's Kiira Motors Corporation for 450 electric buses including charging infrastructure, at a reported USD 150 million — the largest announced electric bus procurement in the region. At Golden Arrow's normal recapitalisation rate of 60 to 65 buses a year, the Kiira contract alone represents roughly seven years of fleet replacement, which is why its delivery schedule spans multiple years.
Yes. Volvo Buses announced an order for 38 BZR Low Entry Electric buses for the City of Cape Town in August 2026, funded through the Public Transport National Grant, with bodies manufactured locally by Gauteng Bus and Coach Centre and first deliveries scheduled from 2027. The city has stated that 38 is a minimum that may increase with funding availability. Cape Town began real-world testing of its first twelve-metre locally bodied Volvo BZR Low Entry Electric MyCiTi bus in July 2026, assessing battery performance, energy consumption, charging time, passenger loading and route conditions ahead of wider rollout.
Three suppliers account for all committed volume, each with a different entry strategy. BYD holds operating incumbency through the 120-bus Golden Arrow programme, using B12 units with 230 kilowatt hour batteries charging in approximately two hours, and holds the only substantial South African operating dataset. Volvo Buses holds the municipal beachhead with 38 BZR Low Entry Electric units for Cape Town, specified at up to 630 kilowatt hours across seven 90 kilowatt hour packs and locally bodied. Kiira Motors Corporation of Uganda holds the largest single contract at 450 buses. None of these positions is yet secure across more than one customer.
Far more than the vehicles suggest. Smart EV's December 2025 hub at Golden Arrow's Arrowgate depot installed 30 plus 20 dual-gun 120 kW direct-current chargers and increased grid supply from 1 MW to 6 MW, enabling as many as 100 buses to charge in about 90 minutes; the installation has since grown to 60 charging stations serving up to 120 buses. That implies roughly 60 kilowatts of depot grid capacity per bus in high-throughput operation. Applied to the 3,200-unit 2031 forecast, it implies approximately 192 megawatts of new depot grid capacity nationally, and about 36 megawatts for the 608-unit committed fleet. Electricity connection lead times and funding are the most important practical constraints on how quickly contracted buses become operating buses.
Because procurement in this market is concentrated in a handful of buyers, so the series moves in discrete blocks when a contract is signed rather than continuously as demand accumulates. The committed fleet rose from 120 units in 2025 to 608 in 2026 — a 406.67% single-year increase produced entirely by two contract signatures. That step is why the six-year rate of 72.85% and the five-year rate of 39.40% diverge by 33.45 points, the widest spread in this research programme. A compound rate applied here will be wrong in every intermediate year even if it happens to be right at the endpoints, and customer-by-customer procurement tracking is materially more predictive.
Approximately USD 333,333 to USD 341,530 per bus including charging infrastructure, on the two independently reported reference transactions. The Kiira Motors agreement covers 450 buses with charging infrastructure at USD 150 million, implying USD 333,333 each. Golden Arrow's reported R750 million total investment in its delivered 120-bus programme implies USD 341,530 at a constant ZAR 18.30 per USD. The two differ by 2.46% despite being reached by entirely different routes, which is what allows a capital value series to be published in a market with only three transactions. A per-bus figure quoted without infrastructure would be roughly a third lower and would price a product nobody in this market actually buys.
Yes. Marqstats offers 20% complimentary customization on country reports and 25% on global reports. The highest-value extensions on this study are customer-by-customer procurement pipeline tracking, which is materially more predictive than any compound rate in a market this concentrated; depot-level grid capacity and connection lead-time assessment against the 60 kilowatt per bus benchmark; total cost of ownership modelling using Golden Arrow's observed consumption near 0.99 kilowatt hours per kilometre; local bodying and aftersales capability assessment for tender positioning; and municipal grant cycle mapping for procurement timing. The report is delivered as a PDF, an Excel data workbook containing the full fleet, capital value, operator, supplier, deployment stage, bus class, value chain and provincial tables together with the contract register and grid ratio assumptions, and a PowerPoint summary.
